four stages im

What Are the Four Stages of Injection Molding? Complete Process Breakdown

The four stages of injection molding are: (1) Injection — molten plastic fills the closed mold cavity under high pressure; (2) Packing — additional pressure compensates for material shrinkage; (3) Cooling — the plastic solidifies as heat is removed; (4) Ejection — the mold opens and finished parts are pushed out by ejector pins. This cycle repeats every 10–60 seconds.

Further Reading

For neutral technical background, see injection molding background.

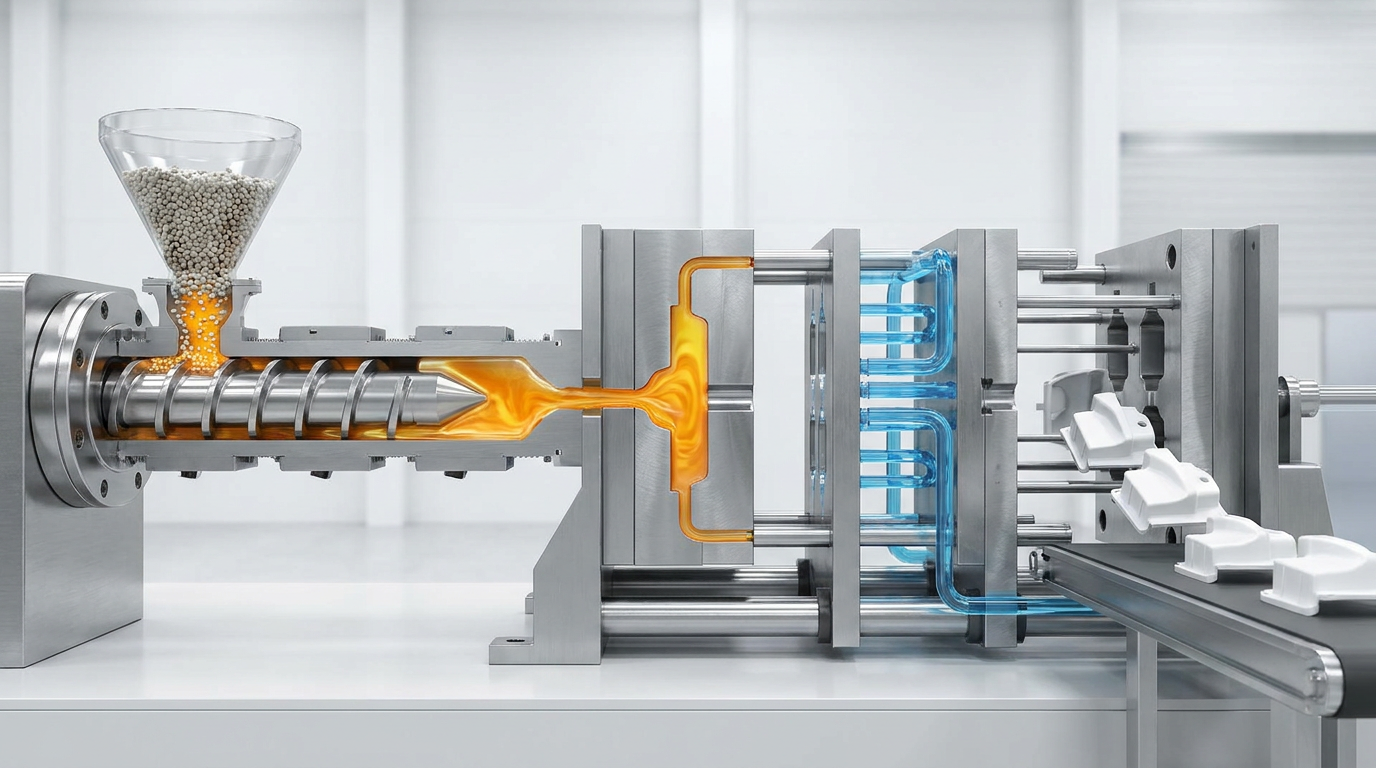

The four stages of injection molding process diagram

Stage 1: Injection — Filling the Mold

The injection stage begins when the reciprocating screw moves forward like a plunger, pushing molten plastic from the barrel through the nozzle, into the sprue, along the runner channels, through the gates, and finally into the mold cavity.

Parameter Typical Range Effect on Part Quality
Injection speed 50–500 mm/s Too slow: freeze-off, short shot • Too fast: flash, burn marks
Injection pressure 500–2,000 bar Insufficient: short shot • Excessive: flash, residual stress
Fill time 0.5–5 seconds Faster fill reduces cycle time but increases shear heating
Transfer point 95–98% full cavity Too early: short shot • Too late: flash and overpacking

Key principle: Injection stops at approximately 95–98% cavity fill. The final 2–5% is completed during the packing stage. This “transfer point” from injection to packing is one of the most critical process parameters in injection molding.


Stage 2: Packing (Holding) — Compensating for Shrinkage

After the cavity is filled, the process transitions to the packing (or holding) phase. The screw continues to apply lower, controlled pressure to push additional material into the cavity as the plastic begins to cool and shrink.

  • Pack pressure: Typically 50–80% of peak injection pressure
  • Pack time: 2–15 seconds, determined by gate freeze-off time
  • Insufficient packing: Sink marks, internal voids, underweight parts, dimensional variation
  • Excessive packing: Flash near gate, high residual stress, part sticking, difficult ejection
  • Gate freeze test: Weigh parts at increasing pack times until weight stabilizes — that point is the minimum effective pack time

Stage 3: Cooling — Solidifying the Part

Cooling begins simultaneously with packing and continues after pack pressure is released. Cold water (or temperature-controlled fluid) circulates through channels machined into the mold, extracting heat from the part until it is rigid enough to be ejected without distortion.

Factor Detail Impact
Cooling time 5–40 seconds 60–70% of total cycle time — the dominant variable
Mold temperature 20–60°C (amorphous) • 60–120°C (semi-crystalline) Affects crystallinity, surface finish, warpage
Coolant temperature 10–40°C water Lower temp = faster cooling but risk of condensation
Cooling channel design 1.5× diameter from cavity surface Poor design = hot spots, sink marks, warpage
Conformal cooling 3D-printed channels following part contour 20–40% cycle time reduction in complex molds

Stage 4: Ejection — Removing the Finished Part

When the part has cooled sufficiently below its heat deflection temperature (HDT), the mold opens and the ejector system activates to push the part out of the cavity.

  • Ejector pins: Most common method. Hardened steel pins push against the B-side (non-cosmetic) surface. Pin marks are visible and must be positioned in non-cosmetic areas
  • Stripper plate: A moving plate strips the part off the core — used for thin-wall containers and tubular parts where pin marks are unacceptable
  • Air assist: Compressed air injected into the cavity helps release parts from deep cores or low-draft surfaces
  • Robot removal: High-volume production uses robotic arms to remove, orient, and place parts on conveyors or into inspection stations
  • Early ejection risk: Ejecting before HDT causes warpage, surface deformation, and dimensional non-conformance

Complete Cycle Time Breakdown

Stage Duration % of Cycle Key Optimization
Mold close 1–3s 5% Optimize clamp speed profile
Injection (fill) 0.5–5s 5% Increase speed within flash limit
Packing 2–15s 15% Minimize to gate freeze-off point
Cooling 5–40s 65% Primary optimization target
Mold open 1–3s 5% Fast-open profile
Ejection 0.5–2s 5% Automate with robot

Frequently Asked Questions

What is the most important stage of injection molding?

Cooling is the most important stage for productivity because it accounts for 60–70% of total cycle time. However, the injection and packing stages have the greatest influence on part quality — defects like sink marks, weld lines, and dimensional variation are primarily set during these stages.

What happens between injection and packing?

The transition from injection to packing is called the “transfer point.” At this point, control switches from velocity (injection) to pressure (packing). The transfer typically occurs when the cavity is 95–98% full, detected by screw position, cavity pressure sensor, or time.

Can the four stages overlap?

Yes. Cooling begins as soon as molten plastic contacts the mold wall — before the cavity is even full. Packing and cooling overlap significantly. Only injection and ejection are truly sequential and non-overlapping.

Why does cooling take so long?

Plastic is a very poor thermal conductor — approximately 1,000 times worse than steel. Heat must diffuse slowly from the plastic through the mold wall to the coolant. Reducing wall thickness and improving cooling channel placement are the primary ways to reduce cooling time.
