cycle time v2

How Long Does Injection Molding Take? Cycle Time & Lead Time Guide

Injection molding involves two very different timelines: cycle time (how long one shot takes — typically 10–60 seconds) and mold build lead time (how long to manufacture the mold — typically 4–12 weeks). A single injection molding cycle producing a finished part takes less than a minute; building the mold that makes those parts takes weeks. Understanding both is essential for project planning.

Further Reading

For neutral technical background, see injection molding background.

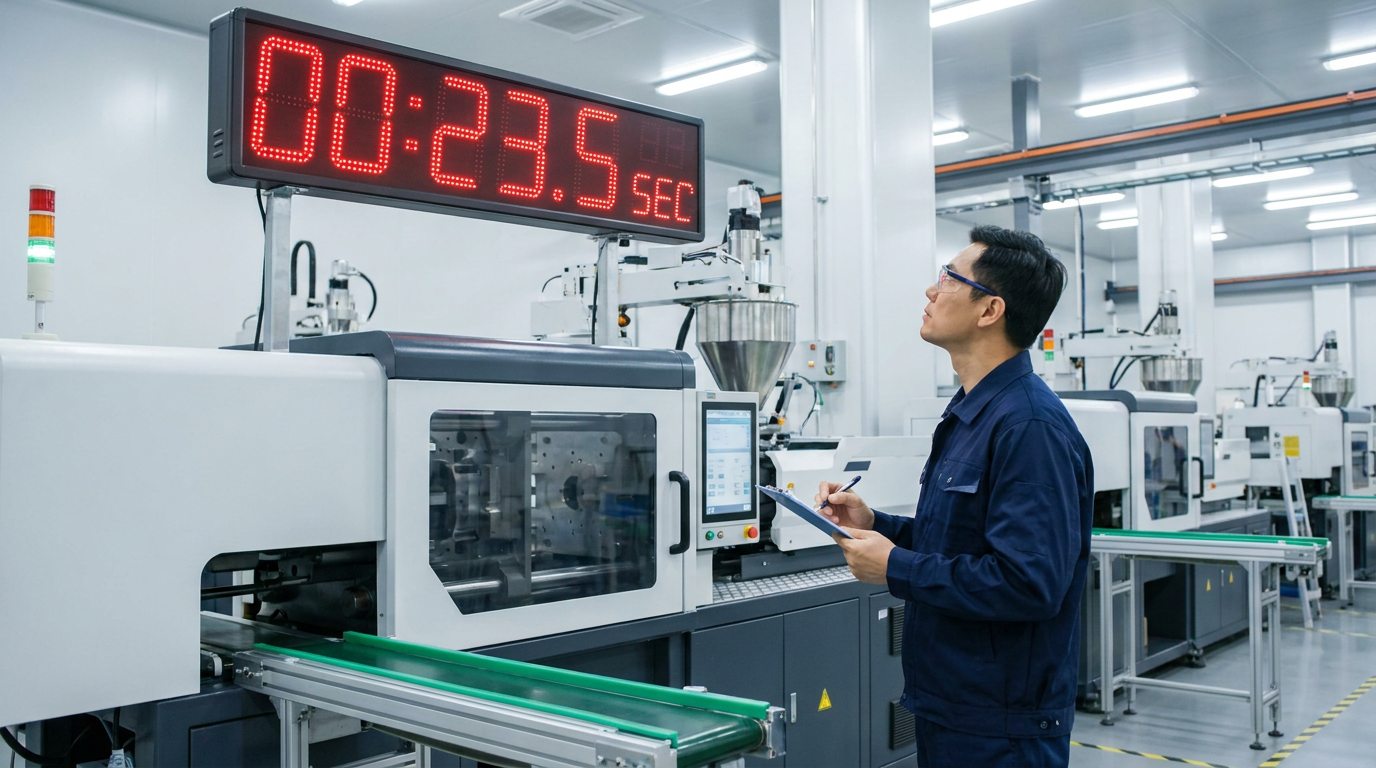

Injection molding cycle time display showing 23.5 seconds

Part 1: Injection Molding Cycle Time (Seconds to Minutes)

The injection molding cycle time is the time from one mold opening to the next — including closing, injection, packing, cooling, opening, and ejection. It determines how many parts the machine produces per hour.

Part Type Wall Thickness Typical Cycle Time Parts per Hour (1 cavity)
Thin-wall packaging 0.5–1.0mm 5–12 seconds 300–720
Small consumer part 1.0–2.0mm 10–20 seconds 180–360
Standard plastic part 2.0–3.5mm 20–45 seconds 80–180
Thick structural part 3.5–6.0mm 45–90 seconds 40–80
Very thick/large part 6.0mm+ 90–300 seconds 12–40

What Controls Cycle Time?

Cooling time accounts for 60–70% of total cycle time and is the primary optimization target:

Stage Typical Duration % of Cycle Key Variables
Mold close 0.5–3s 5% Clamp speed setting
Injection (fill) 0.5–5s 5% Injection speed, gate size
Packing 2–15s 15% Pack pressure, gate freeze time
Cooling 5–60s 65% Wall thickness, mold temp, coolant
Mold open + eject 1–4s 10% Machine speed, robot time

How to Reduce Injection Molding Cycle Time

  • Reduce wall thickness — Cooling time scales with the square of wall thickness. Reducing from 3mm to 2mm cuts cooling time by ~55%
  • Lower mold temperature — Colder mold = faster cooling, but too cold causes surface defects and poor crystallinity in semi-crystalline materials
  • Improve cooling circuit design — Channels closer to the cavity surface extract heat faster. Conformal cooling (3D-printed channels) reduces cycle time by 20–40% in complex molds
  • Minimize pack time — Run a gate freeze study to find the minimum effective pack time. Every unnecessary second adds directly to cycle time
  • Use hot runner systems — Eliminates runner cooling time; allows shorter overall cycles
  • Automate part removal — Robots remove parts faster and more consistently than manual operators, reducing the mold-open time

Part 2: Mold Manufacturing Lead Time (Weeks)

Before any parts can be injection molded, the steel mold must be designed and built. This is a completely separate timeline:

Mold Complexity Description Lead Time to T1 Sample
Simple Single cavity, no sliders, standard steel 4–6 weeks
Medium 2–4 cavities, 1–2 sliders 6–9 weeks
Complex Hot runner, multiple sliders, complex geometry 8–14 weeks
High precision Medical/optical, tight tolerances, special steel 10–18 weeks
Large automotive Bumpers, large panels, multi-cavity 14–24 weeks

The mold build timeline includes: DFM analysis (3–5 days) → mold design (5–10 days) → steel procurement (5–14 days) → CNC machining and EDM (14–30 days) → fitting, polishing, assembly (5–10 days) → T1 trial (1–3 days).


Total Project Timeline: From Drawing to Production Parts

Phase Duration Key Activities
RFQ and DFM review 1–5 days Submit drawing; receive DFM report and quotation
Mold design and approval 5–14 days 3D mold design; customer approval
Mold manufacture 3–10 weeks CNC, EDM, fitting, polishing
T1–T3 mold trials 1–4 weeks First shots, optimization, FAI
Production startup 1–2 weeks Process documentation, operator training
Total: simple mold 6–10 weeks Drawing to production parts
Total: complex mold 12–20 weeks Drawing to production parts

How long does one injection molding shot take?

A single injection molding cycle (one shot) typically takes 10–60 seconds for standard thermoplastic parts. Thin-wall packaging can cycle in 5–12 seconds. Very thick or large parts may require 2–5 minutes. The cycle time determines parts-per-hour output.

How long does it take to build an injection mold?

A standard single-cavity injection mold takes 4–6 weeks from design approval to first sample (T1). Complex multi-cavity or hot runner molds take 8–14 weeks. High-precision medical or optical molds may require 12–18 weeks.

Can injection molding lead time be shortened?

Yes. Lead time can be reduced by: overlapping DFM and steel procurement (saves 1–2 weeks), choosing simpler gate designs, selecting in-stock steel grades, and working with suppliers who have dedicated capacity. Aluminum soft tooling can reduce lead time to 1–3 weeks but sacrifices tool life.

How many parts can injection molding produce per day?

A single-cavity mold cycling every 30 seconds produces ~2,880 parts per 24-hour day. An 8-cavity mold at the same cycle produces ~23,000 parts per day. High-speed thin-wall molds with 32+ cavities can produce hundreds of thousands of parts per day.
